Implementation Status:

1.Component A: Early warning dissemination systems

ØThe State appointed “The Telecommunication Consultant India Limited (TCIL)” as the technical consultant for the preparation of DPR , Bid documents, Procurement, Implementation, Supervision, Testing, Commissioning and Training for a consultancy fee of Rs 1.73 cr.

ØTender floated for the “ Design, Supply, Installation, Testing, Commissioning, and Services of Early Warning Dissemination System (EWDS) and its of Last Mile Connectivity for the State covering all 14 districts.

ØThe Detailed Project Report (DPR) amounting Rs 66.83 cr. ( against a sanctioned amount of Rs.15.00 cr.) furnished by TCIL. Out of this NDMA has consented to provided Rs. 59.00 cr. and balance Rs. 7.83 cr. is AMC and is to born by the State.

Technical Design for Component A



Implementation Status:

  1. Component B: Cyclone Risk Mitigation Infrastructure

No

Name of MPCS

Plinth Area m2/ft2

Capacity

Awarded Sum

Name of Contractor

Commencement date

Completion

date

Current Stage

1.

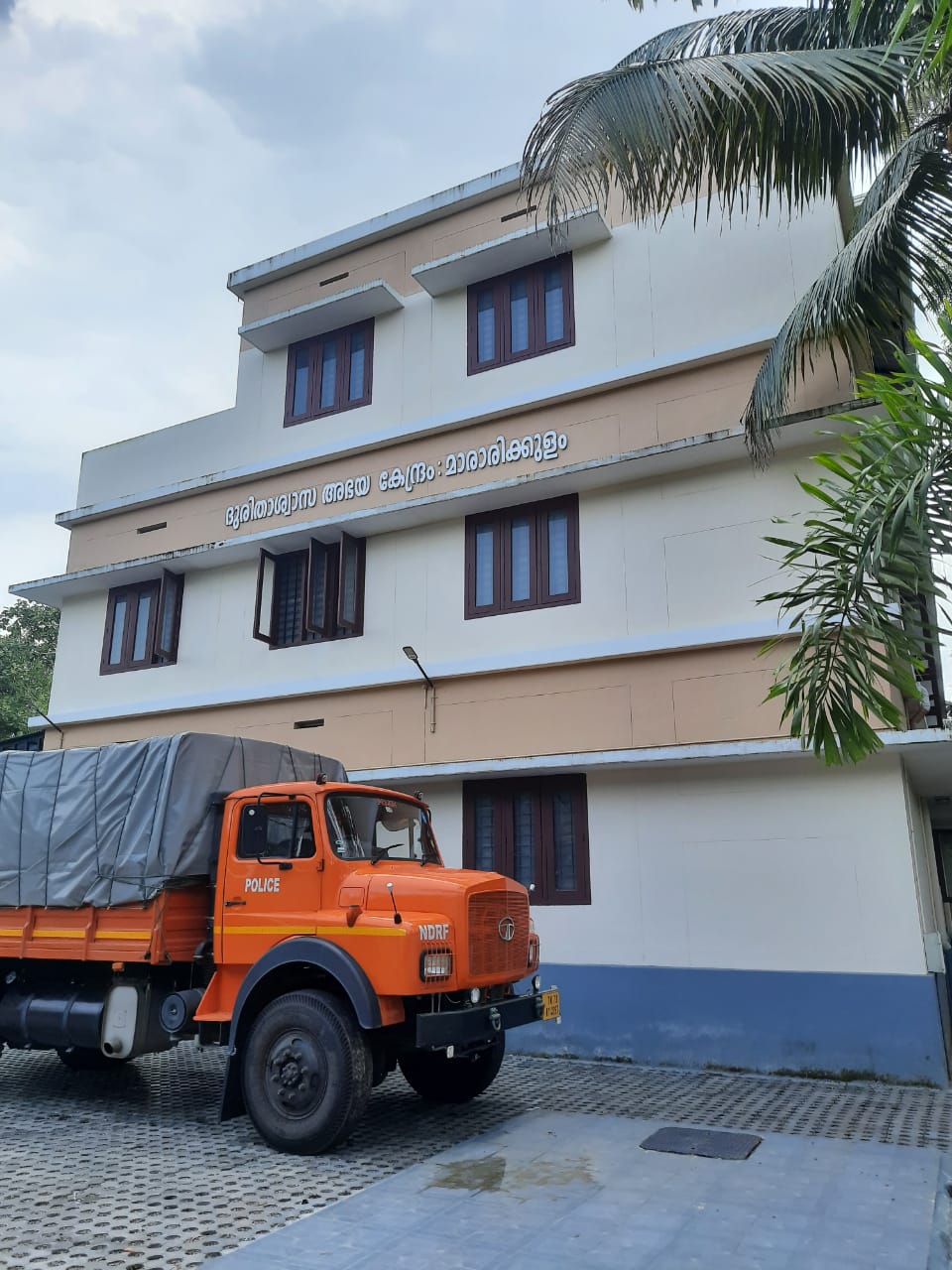

Mararikulam North,

Cherthala

(Revenue land)

830 m2

/8930 ft2

700-900

 ₹ 3,53,88,736.00

 J & J Associates

26-10-2018

29-07-2020

Completed

2.

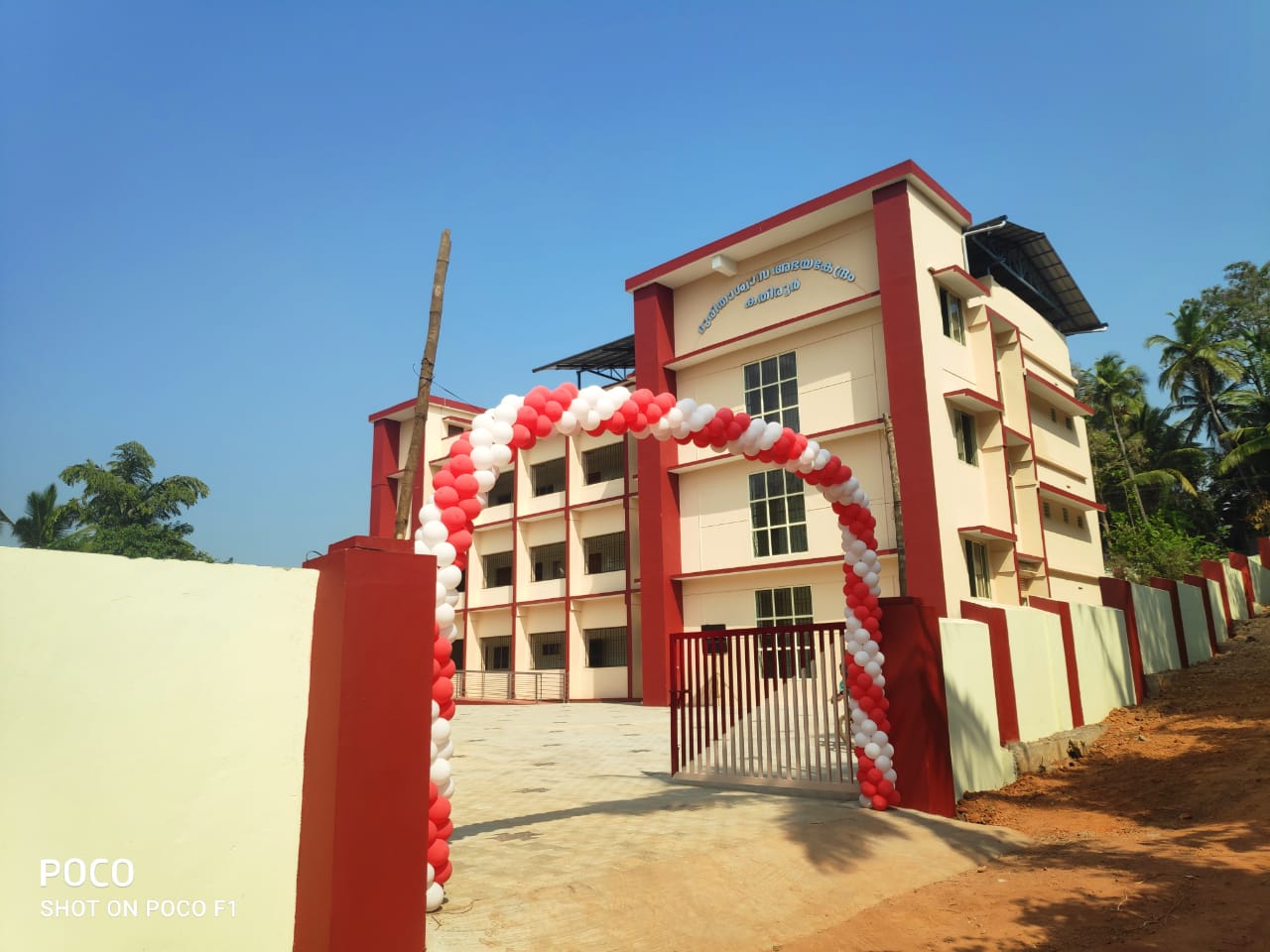

Kathiroor/Ponniam,

Kannur

(Revenue land)

975 m2

/10491 ft2

800-1000

 ₹ 3,19,99,735.00

 Thomas Kannanthanam

05-03-2019

30-02-2021

Completed

3.

Pullur/Hosdurg,

Kasargode

(Revenue land)

975 m2

/10491 ft2

800-1000

 ₹ 3,28,28,418.00

 V K Manojan

21-06-2019

10-12-2021

Completed

4.

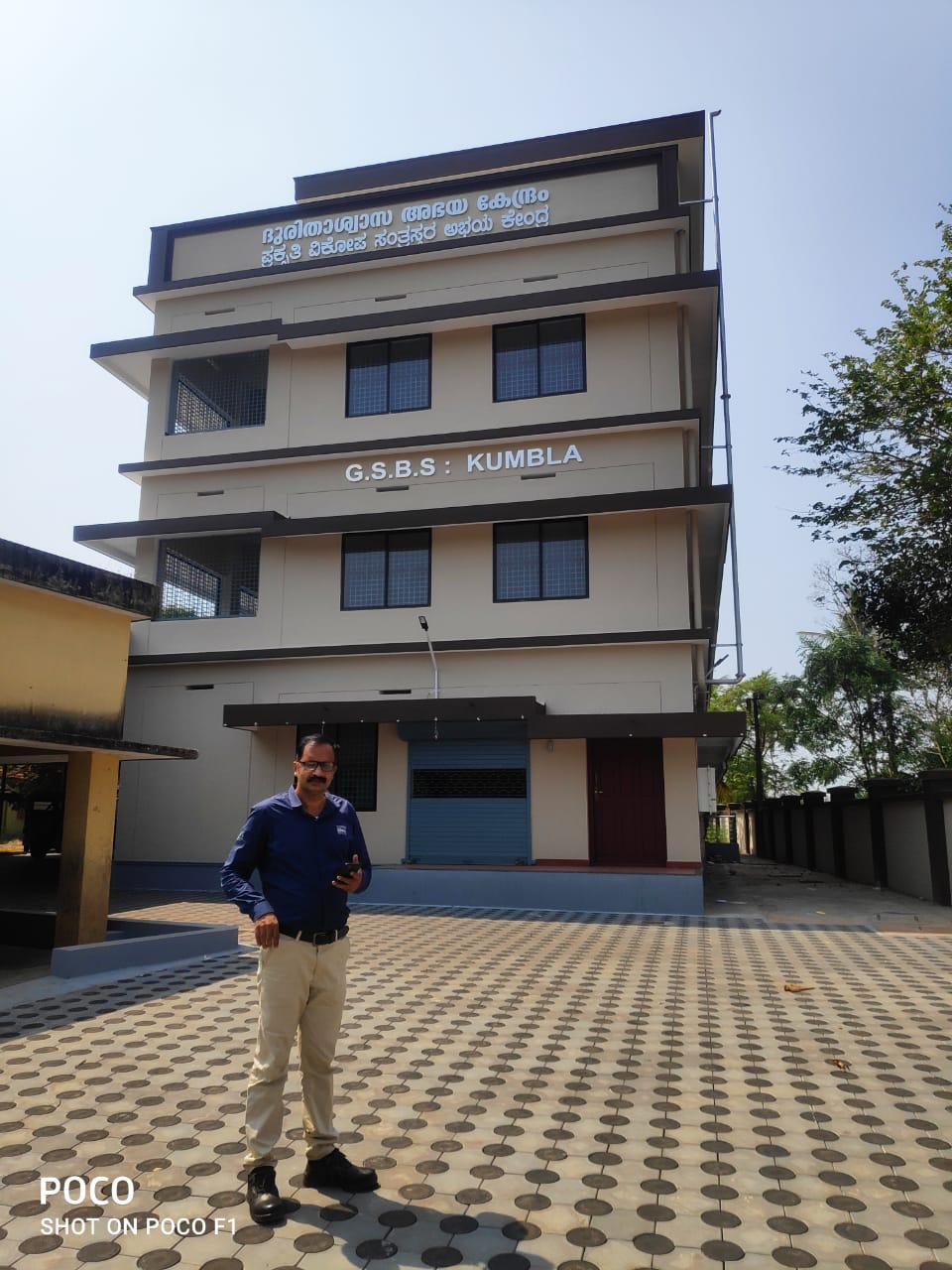

Koipady / Kumbla,

Kasargode

(Education land)

819 m2

/8812 ft2

650 850

 ₹ 2,17,26,319.00

 U K Mohammed

21-06-2019

27-02-2021

Completed

5.

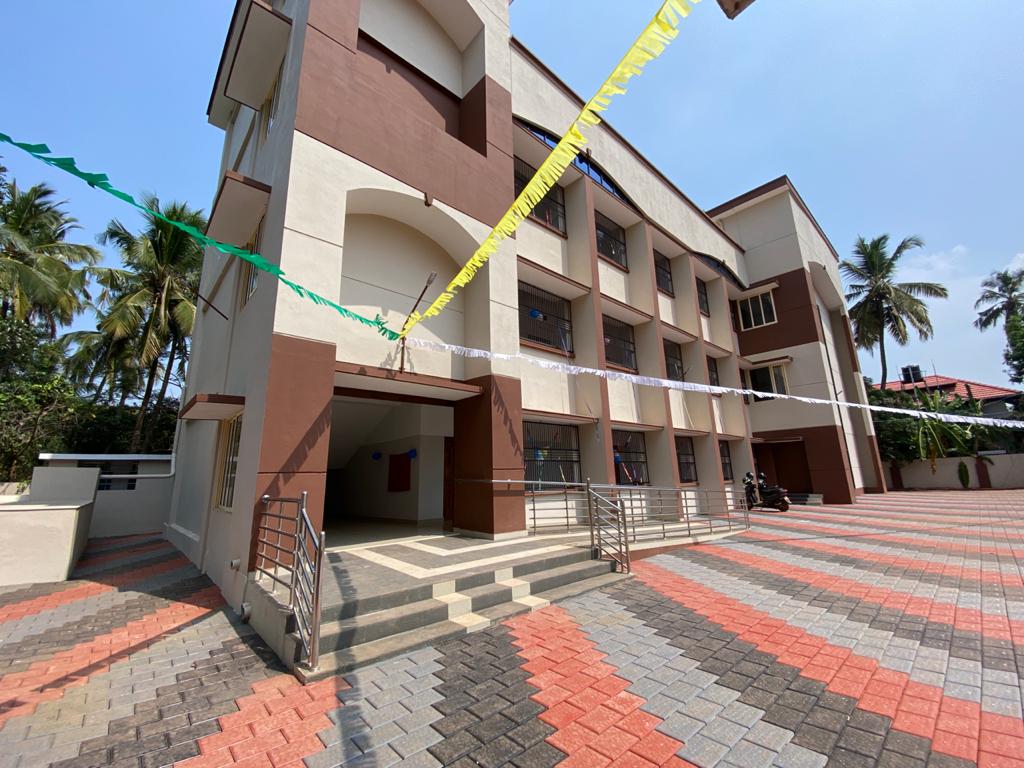

Kannur / Chalad,

Kannur

(Education land)

975 m2

/10491 ft2

800-1000

 ₹ 3,05,55,448.00

 T P Prakashan

21-06-2019

21-10-2021

Completed

6.

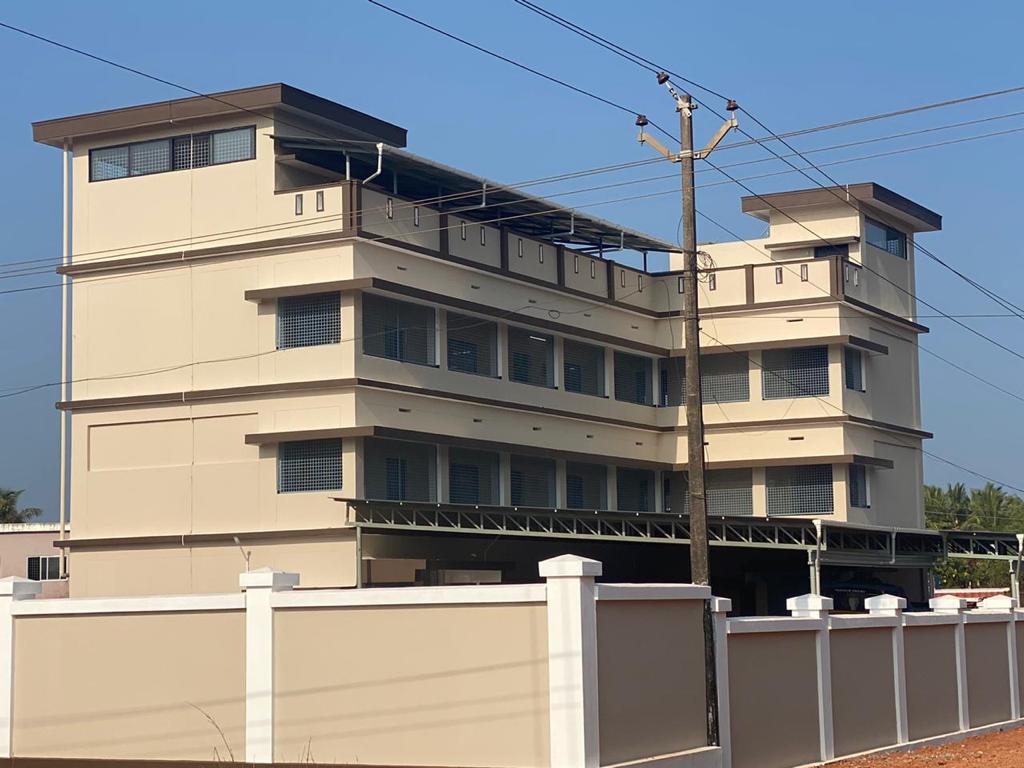

Kudlu / Madhur GP ,

Kasargode

(Revenue land)

862 m2

/9275 ft2

750-950

 ₹ 2,58,24,353.00

 Mohammed Haneef

21-06-2019

21-10-2021

Completed

7.

Thazhava ,

Kollam

(Revenue land)

877 m2

/9436 ft2

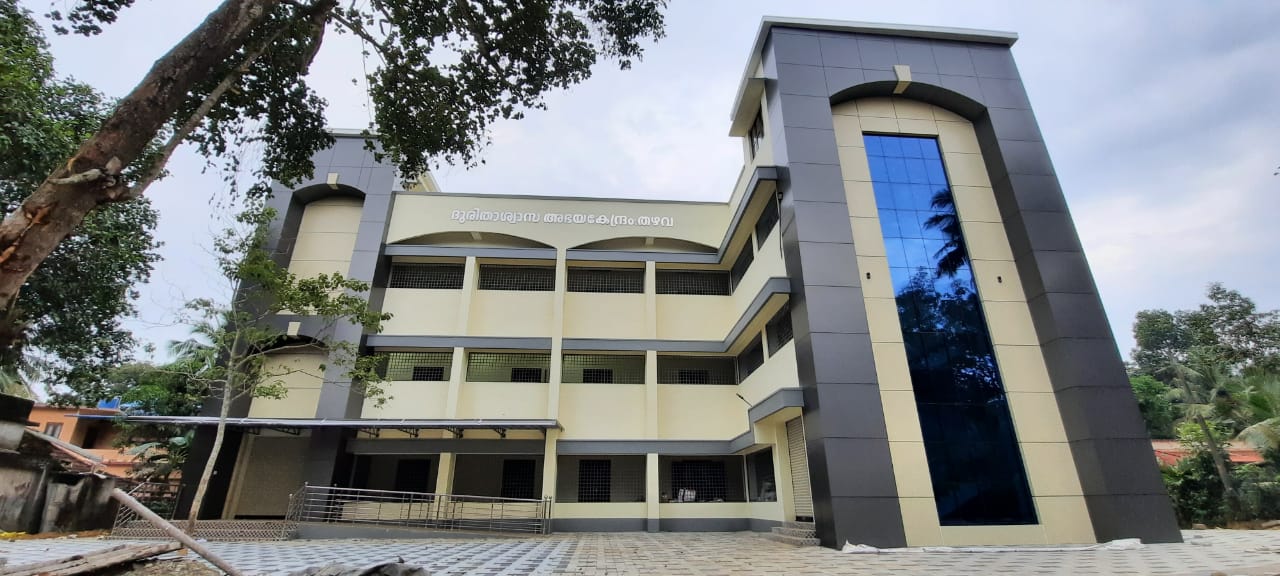

750-950

 ₹ 3,03,81,491.00

 Ismail Kutty

01-09-2019

21-02-2021

Completed

8.

Palappetty

,Malappuram (Education land)

735 m2

/7908 ft2

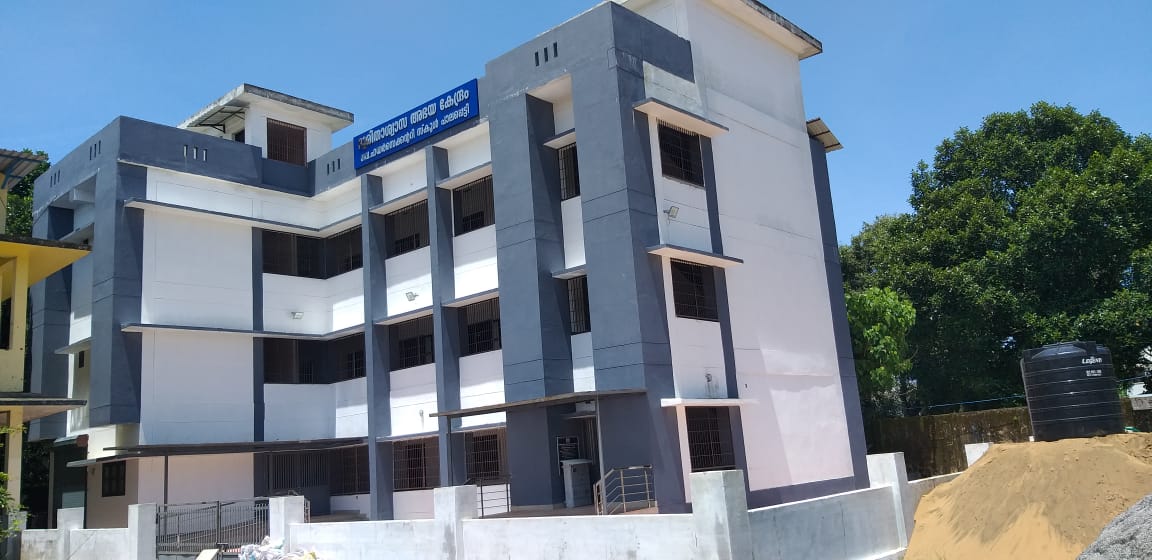

600-800

 ₹ 1,89,46,684.00

 Musthafa K T

01-09-2019

28-09-2021

Completed

9

Vettom/ Paravanna ,Malappuram

(Education land)

1072 m2

/11534 ft2

900-1100

₹     2,86,63,680.00

Musthafa K T

01-09-2019

28-09-2021

Completed

10

Azhikode, Thrissur

(Revenue land)

742 m2

/7983 ft2

600 – 800

 ₹      2,91,48,736.00

 Rasheed C

01-09-2019

02-10-2021

Completed

11

Thuruthipuram, Ernakulam

(Education land)

995 m2

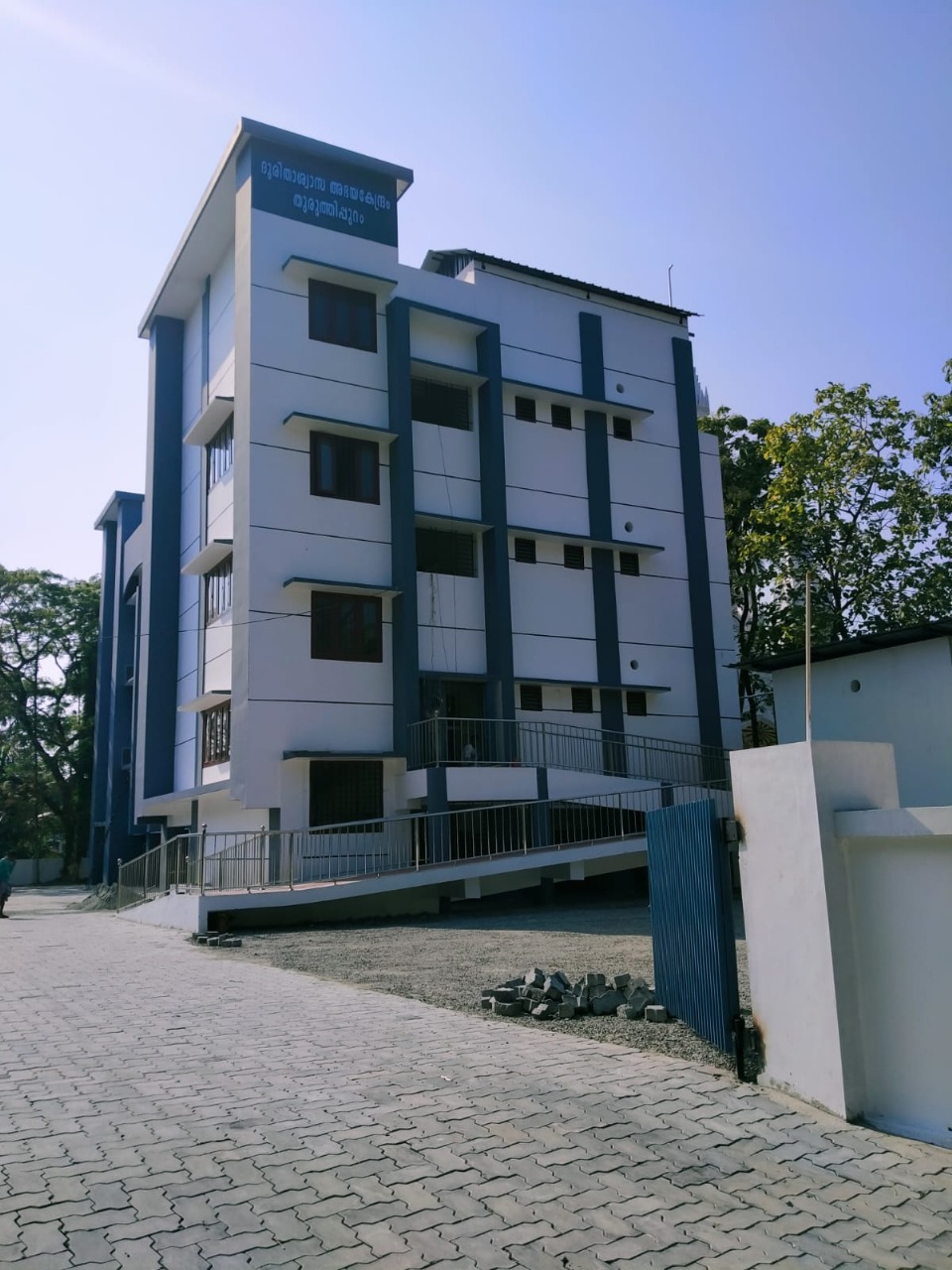

/10706 ft2

800 – 1000

₹      5,56,84,243.00

Rasheed C

01-09-2019

01-04-2022

Completed

12

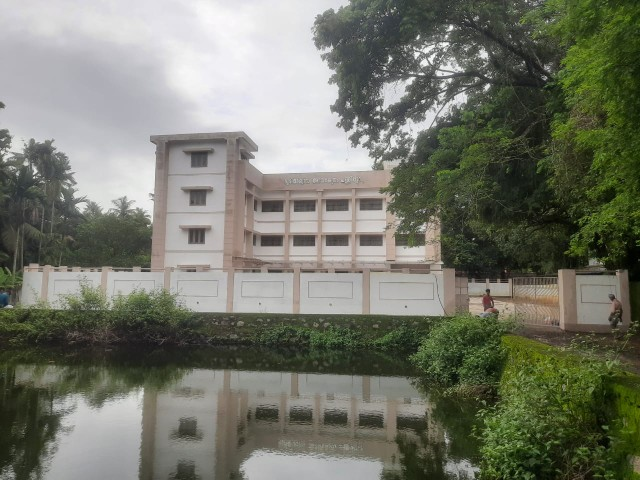

Pallipuram, Ernakulam

(Revenue land)

903 m2/9716 ft2

750 – 950

₹      4,58,10,409.00

Johnson K A

01-09-2019

04-08-2022

Completed

13

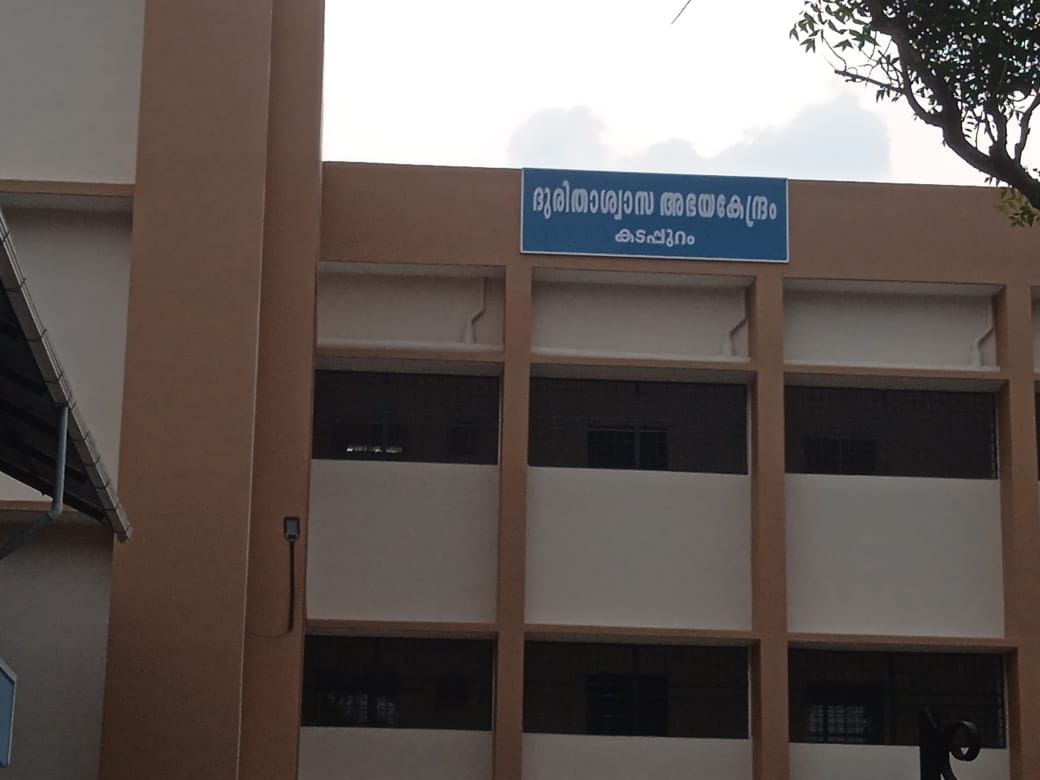

Kadappuram, Thrissur

(Revenue land)

877 m2

/9436 ft2

750 – 950

₹      3,34,78,294.00

Johnson K A

01-09-2019

30-06-2023
(Expected Date to Complete)

Structure Completed. Finishing work in progress

14

Cheruthana, Alapuzha

(Education land)

998 m2

/10738 ft2

800-1000

₹      6,05,47,598.00

J & J Associates

01-09-2019

07-01-2022

Completed

15

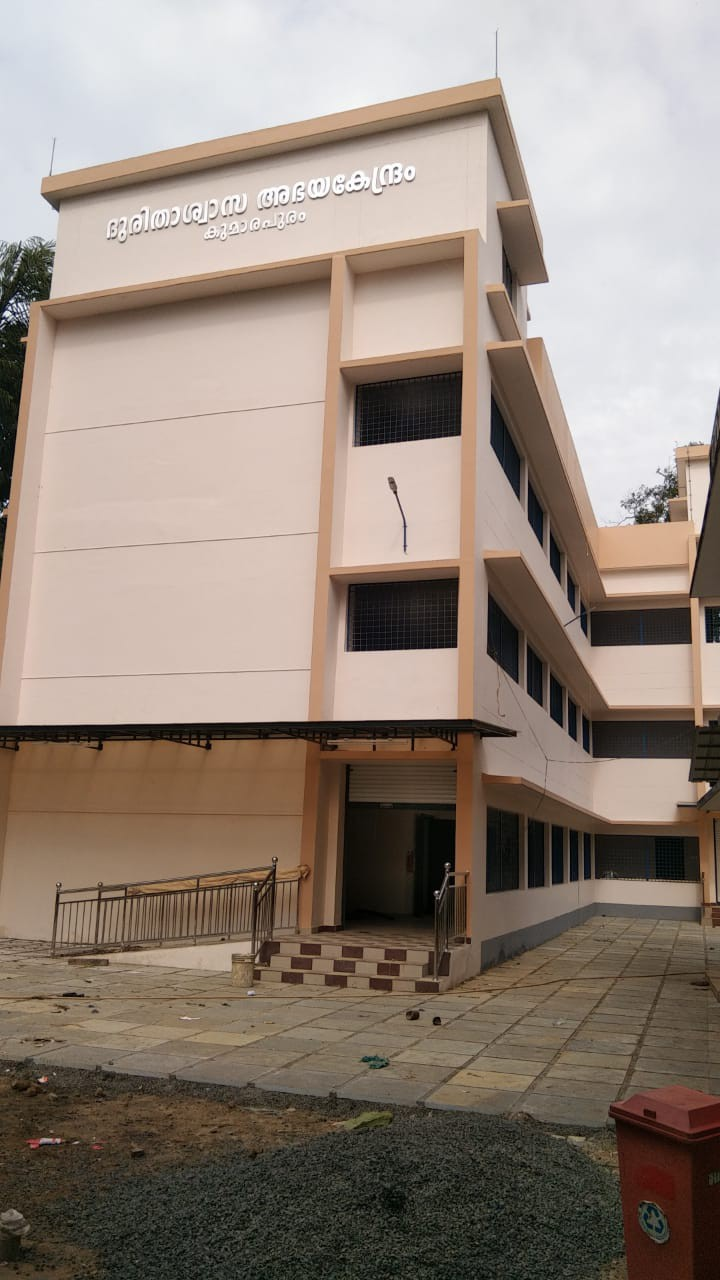

Kumarapuram, Alappuzha

903 m2/9716 ft2

1100-1400

₹      3,40,80,252.00

Ismail Kutty

07-12-2020

26-10-2022

Completed

16

Muttathara, Thiruvananthapuram

862 m2/9355 ft2

1000 – 1300

₹      4,86,45,338.00

Engineers Associates

08-10-2020

31-12-2022

Completed

17

Kasaba, Kozhikode

975 m2/10491 ft2

1150-1500

₹      4,01,57,300.00

Musthafa K T

27-10-2020

14-03-2023 (Expected Date to Complete

Structure Completed. Finishing work in progress



Total

15,343 m2 / 1,65,164 ft2

16,000 to 20,350 people

₹      60,46,67,034.00









        Implementation Status:

  1. Component B: Cyclone Risk Mitigation Infrastructure

Public Consultation Conducted :

Public Consultations were conducted at each site locations to document the views and feedback on the project proposal to consider, during the planning stage. Details



Implementation Status:

  1. Component B: Cyclone Risk Mitigation Infrastructure –
  2. Component D: Project Management & Implementation Support – ~₹7.8 crores: Administrative funds
